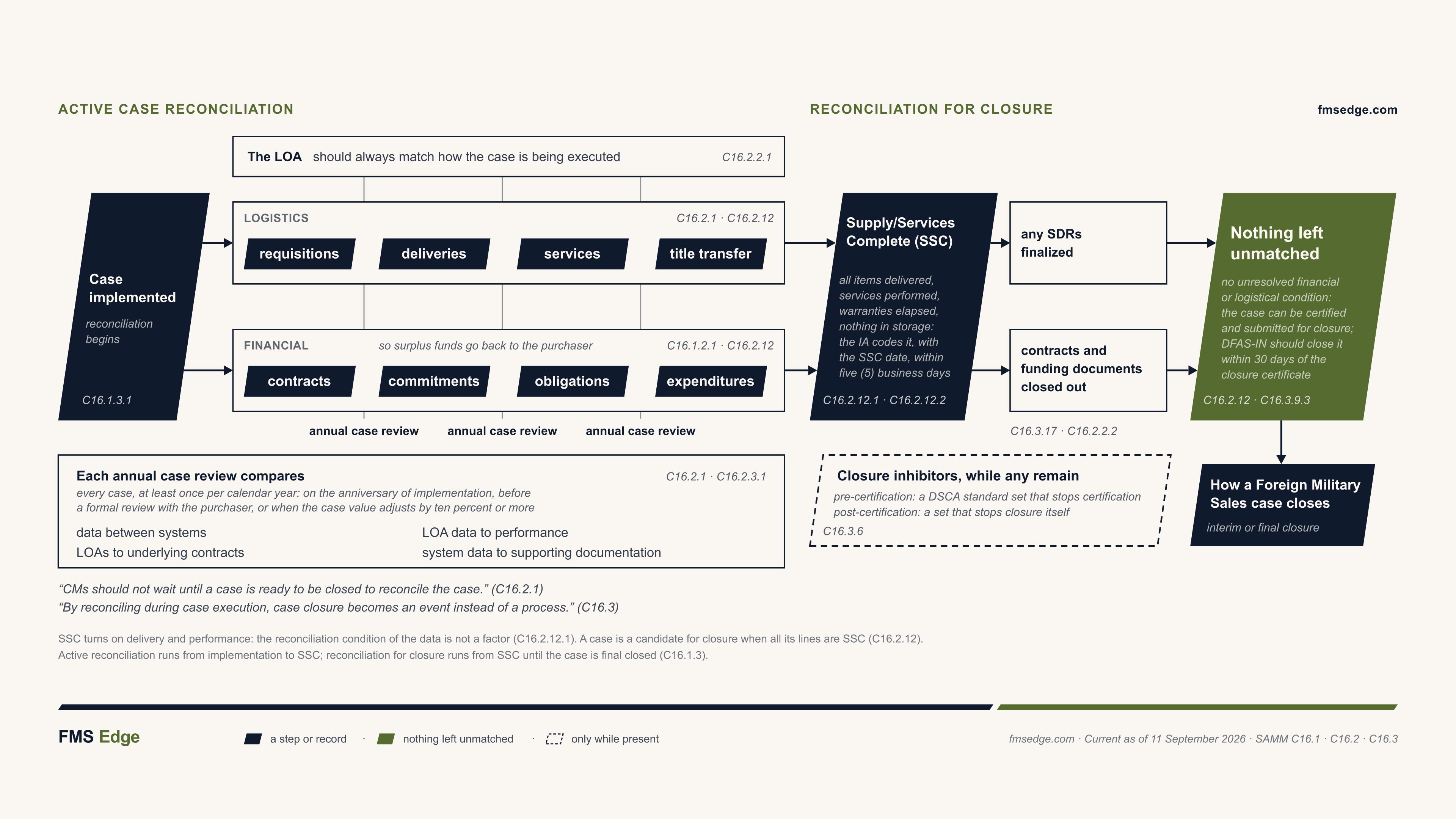

Guide
What is Foreign Military Sales case reconciliation?
Reconciliation is the financial and logistical work that keeps a case's accounting, data, schedules and reporting accurate. It starts when the case is implemented, continues through execution to Supply/Services Complete, and does not end until the case is final closed.
Reconciliation starts when a case is implemented, and each annual case review checks the records against the LOA. After Supply/Services Complete (SSC) it runs until nothing is left unmatched; only then can the case be certified and submitted for closure. What follows is shown in How a Foreign Military Sales case closes.
What is Foreign Military Sales case reconciliation?
Reconciliation refers to the financial and logistical actions that ensure proper accounting, accuracy and thoroughness of data, currency of schedules, and timeliness and completeness of reporting. In turn, successful reconciliation throughout the life of a case expedites case closure [SAMM ]. Case reconciliation is not a single action; rather, it is a series of actions (beginning with case implementation) identifying and resolving discrepancies among logistics and financial transactions throughout the life of a case. Reconciliation commences with the implementation of a case and does not end until the case is “final” closed. Reconciliation for closure involves extensive communication between various logistics, financial, and contract organizations to ensure associated closure transactions are completed. It is imperative that case and line reconciliation be initiated upon implementation of the case to make the closure process timely and easier. By reconciling during case execution, case closure becomes an event instead of a process. Chapter 16 of the sets out the case reconciliation and closure policy, which applies to both and Building Partner Capacity () cases.
Unique closure requirements for cases are provided in C15.7. Information contained in Chapter 16 complements the (). Chapter 16 also identifies all policies in order to facilitate actions and simplify efforts to research the associated business rules and processes provided in the Case Reconciliation and Closure Guide (RCG), which is provided in , Appendix 7.
Active case reconciliation
Active case review and reconciliation, extending from case implementation until the case is Supply/Service Complete (), are critical components of effective case management. It is mandatory that each case manager performs an annual case and review and/or reconciliation on each case, which includes comparing data between systems, comparing case data to performance, comparing cases to underlying contracts and comparing systemic data to hardcopy or electronic supporting documentation. Case managers are responsible for the timely reconciliation and closure certification of cases, regardless of how these activities are delegated within the responsible . Case managers should not wait until a case is ready to be closed to reconcile the case. Case managers should reconcile and close lines of accounting, requisitions, funding documents, and other program documents as material is delivered and services are performed [SAMM ]. Several important reconciliation actions facilitate case closure. These include:
- Continuous, periodic reconciliation of essential financial data to allow for error detection, correction, and future actions at the earliest possible point in the case life cycle
- Establishing a comprehensive file of all transactions pertaining to the case.
- Recording case data with objective evidence. The recording of financial data in source documents will provide an audit trail, which can ensure the safeguarding of international partner and U.S. Government funds
- Ensuring case identifiers are recorded in all financial transactions. When the Department of War accepts a case, it also accepts a fiduciary responsibility, which is completed once final reconciliation is accomplished.
Supply/services complete
Eventually, an active line or case transitions into Supply/Service Complete () status. A process exists (refer to , Appendix 7, Case Reconciliation and Closure Guide (RCG) Figures AP7.C2.F14 and AP7.C2.F15) for deciding that a case or line is . The reconciliation condition of data (other than that which is preventing item delivery or actual completion of services), the allocation of resources (funding and/or manpower), or the distribution/transfer of workload are not factors in determining when occurs. The declares a case or line is when the following events occur by updating the status in the system (to include Date) and informing the international partner [SAMM ]:
- Verification that all items are delivered; title has transferred
- Verification that all services have been performed
- Training: Verification that all courses, Mobile Training Teams () and Extended Training Service Specialist/Language Training Detachments are completed, all Temporary Duties () are finished, and all case-funded salary positions have expired.
- Period of performance for all other services has elapsed
- Program Management Line (): The end point may vary, but may be no later than 12 months after final delivery and/or performance of last non- service for the related case(s). Like any other service, the duration of must be linked to the period of performance [SAMM ]
- All warranty periods have elapsed
- No items are in storage
- If the country is under suspensions and/or sanctions, there are no deliveries pending, and no future deliveries shall occur once sanctions are lifted [SAMM ]
Once a line or case meets the conditions for , the shall code it with that status and the actual date within 5 business days [SAMM ]. The coding goes into Socium and the appropriate information management systems, and it shall not be delayed under any circumstances [SAMM ].
Blanket order lines and cases are generally managed by value, so where appropriate status may be applied to them on the basis of their unused value rather than the absence of open orders, together with the purchaser's agreement that no further activity will occur. Where possible, lines and sublines at should carry the code completed (CMPLTD) or shipped (SHPD) in the Defense Management System () [SAMM ].
When a case enters , the Country Finance Director () in the ( (/FPRE)) will post the CLOSHOLD milestone in , which blocks new amendments, modifications and revisions to the case. To process an amendment or modification on a case under CLOSHOLD for its final reconciliation before closure, the must ask to lift the milestone temporarily, and the request must give a detailed justification for the change [SAMM ]. The will review the request and, if it approves, remove the milestone for as long as the case action needs, then reapply it so that closure can continue [SAMM ].
Each keeps its own To Be Kept Open list of cases in status that still hold residual case funds the partner can execute before the case is closed. On written notification from the authorized signatory of the , the will put a case on its list. The case stays there until requirements are identified for using the residual case value or 180 days pass, whichever comes first, and that initial retention period starts on the date the adds the case to the list. Under Section C16.4 (Legacy Case Closure), cases implemented in 2017 and prior are prohibited from any 's To Be Kept Open list [SAMM ].
Once the partner gives written notice of its intent to spend down the residual funds, the will put the case on its To Be Kept Open list. It will also tell the that the case is staying open while the partner works out how to execute those funds. During that time the will keep CLOSHOLD on the case and will not move it to interim or final closure. The must be notified in writing if the partner decides to execute the residual funds. The will then ask the to remove CLOSHOLD in . After that, the will take the case out of status and off the list, and go ahead with the amendment [SAMM ].
Until the case comes off the list, the is required to follow up with the partner every 60 days. It is also required to report the current status to the Financial Analysis and Compliance Division in 's Office of Business Operations, Financial Policy and Regional Execution Directorate ( (/FPRE/FAC)) through the quarterly case closure reporting process, and that report must include the date the case went on the list [SAMM ]. If the residual case value has not been disposed of after 180 days, the will take the case off the list and then move it to interim or final closure, as applicable [SAMM ].
Each quarter, (/FPRE/FAC) will review the listed cases and remove any that are past the 180-day limit. It will inform the and the of each removal so that the can go ahead with closing the case. At that stage the residual value will be returned to the partner's as part of the closure transaction, under Section C16.3.11 (Disposition of Excess Funds) [SAMM ].
A purchaser that needs longer than the allotted 180 days to settle how it will execute the residual funds must tell the in writing and say how much more time it needs, up to an additional 180 days. The will pass the notice to (/FPRE/FAC) and the , and will show the extended time in its quarterly case closure report [SAMM ].
The policy is meant to let the residual value be used. It is not a blanket endorsement for adding funds to the case that would extend its execution phase and could prolong its reconciliation and closure beyond set standards. cases may also go on the list for other conditions, such as purchaser-unique closure thresholds that has approved. The is required to review the cases added for other conditions every 90 days to decide whether they should stay on the list [SAMM ].
